Case Study 06

Stoke Goldington: a box gutter rebuilt.

A tired box gutter between two slate pitches, stripped out and rebuilt to a proper fall, then lined in EPDM rubber so it finally sheds water the way it should.

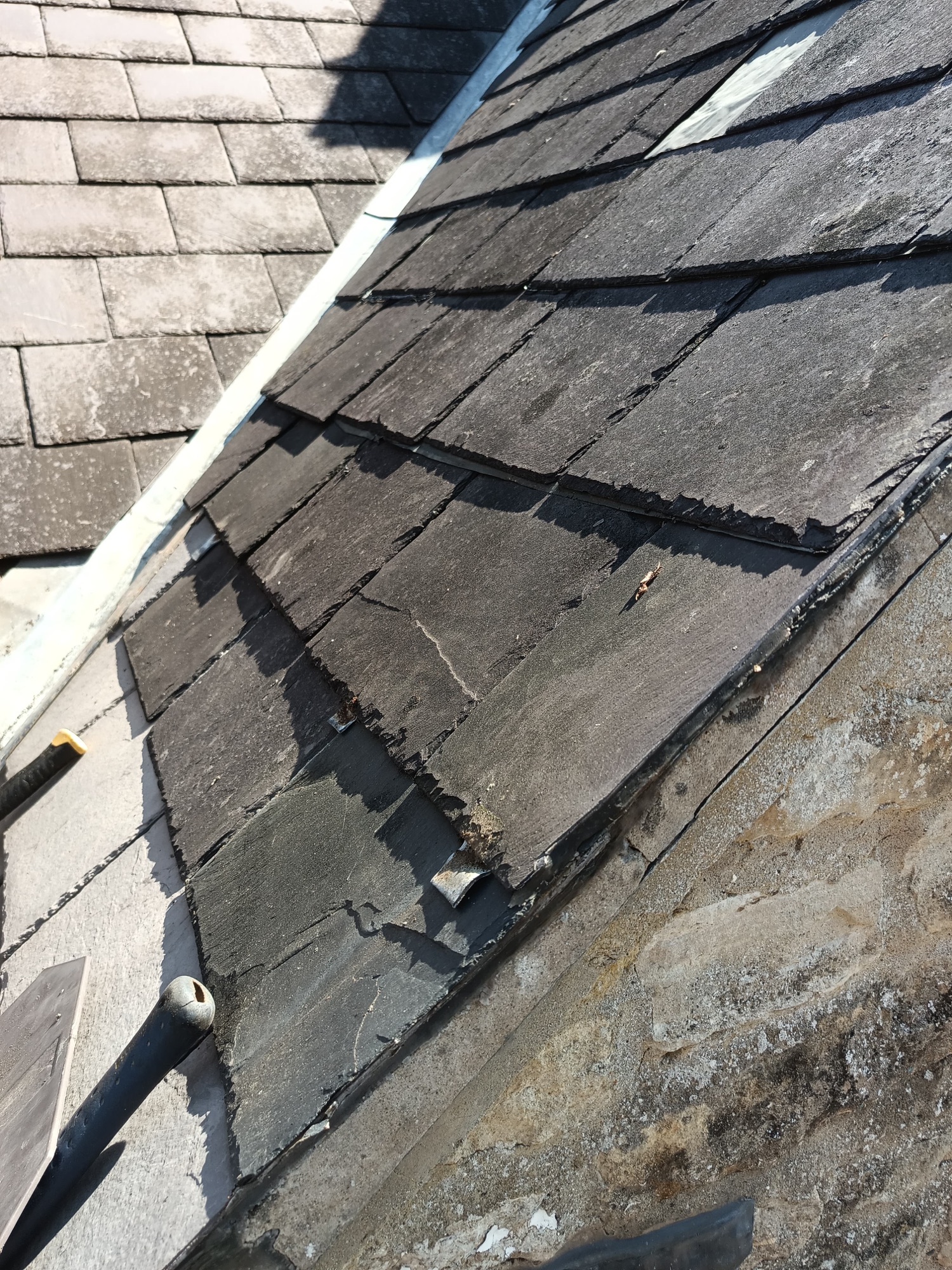

Old failing box gutter between two slate roof pitches before the rebuild Stoke Goldington · 2026
01/Project brief
Project brief

A box gutter that had run out of fall.

The property is stone and slate, with a concealed box gutter running in the valley between two pitches. Over the years the old covering had tired and the gutter had lost what little fall it had, so water sat in it and worked its way back under the slate. The brief was to rebuild it properly: strip it out, re-deck it to a real fall, and line it in a material that will outlast the next patch by decades.

  • DurationAbout a week
  • GutterEPDM rubber
  • The fixRebuilt to a fall
02/Project specification
Specification

The specification.

Every line item, on the record.

Finished EPDM rubber box gutter running between two slate pitches Job No. 06 Case Study · SG
Project card

Stoke Goldington Box Gutter Rebuild

About a week on site · EPDM rubber, rebuilt to fall · Stoke Goldington
01 The brief
ClientPrivate residential ownerLocationStoke Goldington, near Newport PagnellPropertyStone and slate residentialDurationAbout a week on site
02 The build
StripOld covering and tired gutter stripped outDeckBox gutter re-decked and rebuilt to a measured fallCoveringEPDM rubber membrane, dressed up under the slateSlateSlates eased back and re-dressed into the new gutter
03 Sign-off
FallFall checked so water runs to the outlet, no pondingRecordWritten photographic recordRecordWritten photographic record throughout
04/Work breakdown
Stage by stage

Five stages, from strip to rubber.

A box gutter only works if it has fall. The order of operations that took this one from ponding to properly draining.

Old tired box gutter with no fall running between two slate pitches before the rebuildStage 01
01 Strip the gutter

Strip out the old gutter.

The tired old covering was stripped out of the box gutter and the slates along both edges eased back, so we could see the deck and work out exactly how much fall had been lost.

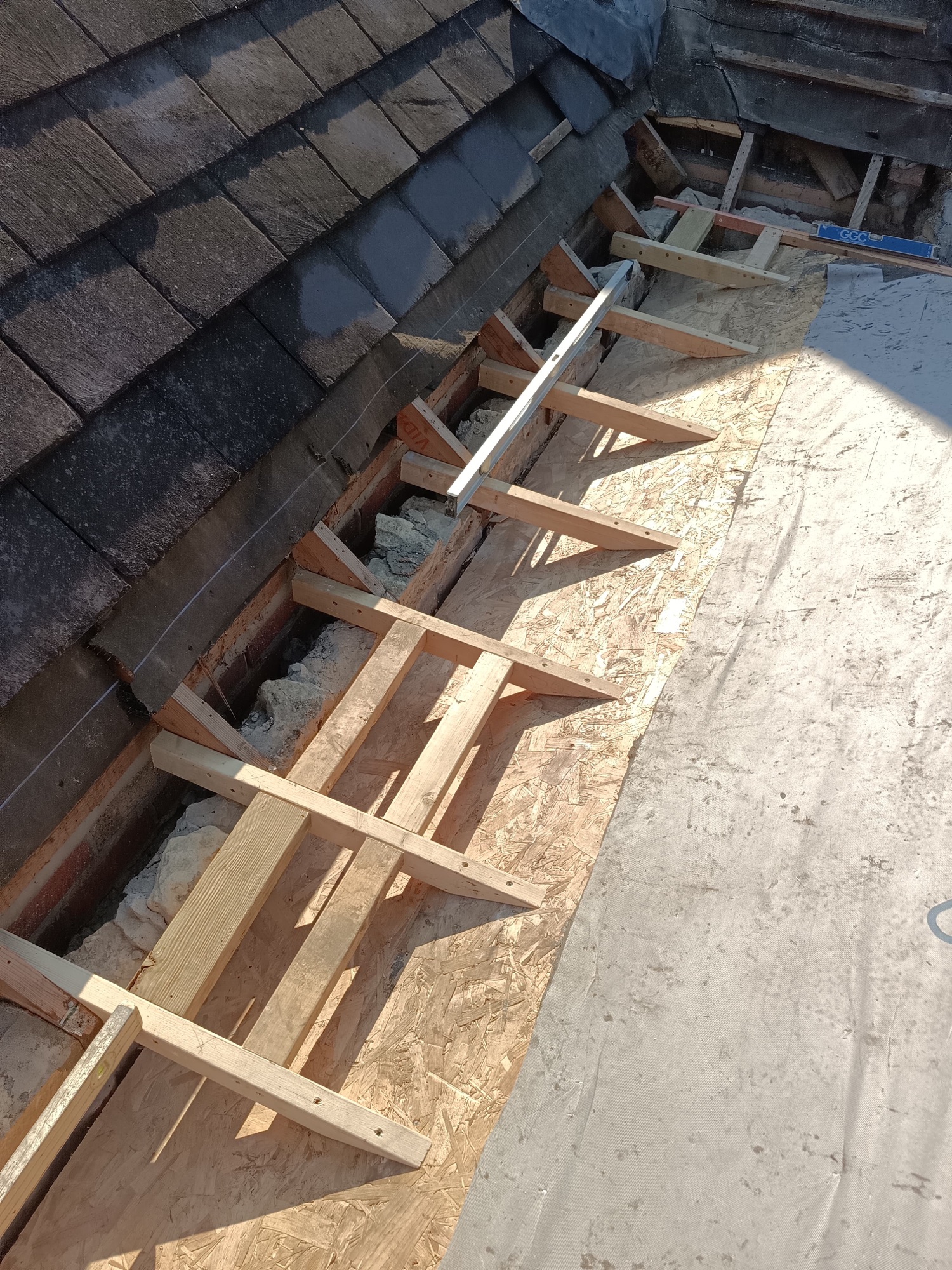

Box gutter stripped out and opened up, old deck taken back to a sound timber baseStage 02
02 Deck back to base

Take the deck back.

The old gutter deck came up. Anything soft or past its life was taken out rather than covered over, back to a sound base to build on.

Gutter re-decked in fresh board and firred to a proper measured fall to its outletStage 03
03 Rebuild the fall

Rebuild to a measured fall.

The gutter was re-decked and firred to a proper measured fall, set out so water runs the length of the gutter to its outlet instead of sitting in the middle. This is the part that actually fixes the leak.

Breathable membrane laid in the box gutter and edges prepped, slates ready to dress backStage 04
04 Membrane and prep

Membrane and prep.

A breathable membrane was laid and the edges prepared, with the slates ready to dress back down over the new gutter upstands on both sides.

Finished EPDM rubber box gutter dressed under the slate on both pitches, draining cleanlyStage 05
05 Rubber and dress in

Rubber it and dress in.

The box gutter was lined in EPDM rubber as one flexible membrane, dressed up under the slate on both pitches so the water is carried cleanly off the roof.

05/Detail gallery
On site

The details that make the finish.

06/Craft note
Why the fall

Why we rebuild the fall, not just the cover.

The tempting way to deal with a leaking box gutter is to lay a new covering straight into the old shape. It looks tidy on the day, but if the gutter had lost its fall then the new covering is holding water just the same as the old one did. The leak comes back, usually the following winter.

The honest fix is to rebuild the deck to a proper measured fall so the water actually runs to the outlet. It is more work, it means easing the slates back on both sides, but it is the difference between a gutter that drains and a gutter that ponds. On this one we set the fall out and checked it before a scrap of covering went down.

EPDM rubber is the right lining for a job like this. It goes down as a single flexible membrane that copes with the movement a long gutter sees, dresses neatly up under the slate, and unlike lead there is nothing on the roof worth stealing. Properly detailed, it is a very long-life answer.

"Bone dry now, first winter in years."
Owner · Stoke Goldington Box Gutter Rebuild · 2026
07/Materials used
What we used

Specified for the roof, not the trend.

Hover any material for the full spec.

EPDM rubber membrane 01
Lining

EPDM rubber membrane

FormationSingle flexible membrane, few joints
DetailDressed up under the slate both sides
AdvantageHandles movement, long life, nothing to steal
Rebuilt gutter deck 02
Structure

Rebuilt gutter deck

WorkRe-decked back to a sound base
Set outFirred to a measured fall
AdvantageWater runs to the outlet, no ponding
Breathable membrane 03
Underlay

Breathable membrane

TypeBreathable, vapour open
WhereAcross the deck and edges
AdvantageKeeps the structure dry beneath
Reclaimed slate, re-dressed 04
Covering

Reclaimed slate, re-dressed

WorkSlates eased back and re-dressed in
WhereBoth pitches into the new gutter
AdvantageReads as one, no patched line
09 · The rebuild in full

The gutter, from strip to finish.

01 · The old box gutter
01 · The old box gutter
02 · Stripped out
02 · Stripped out

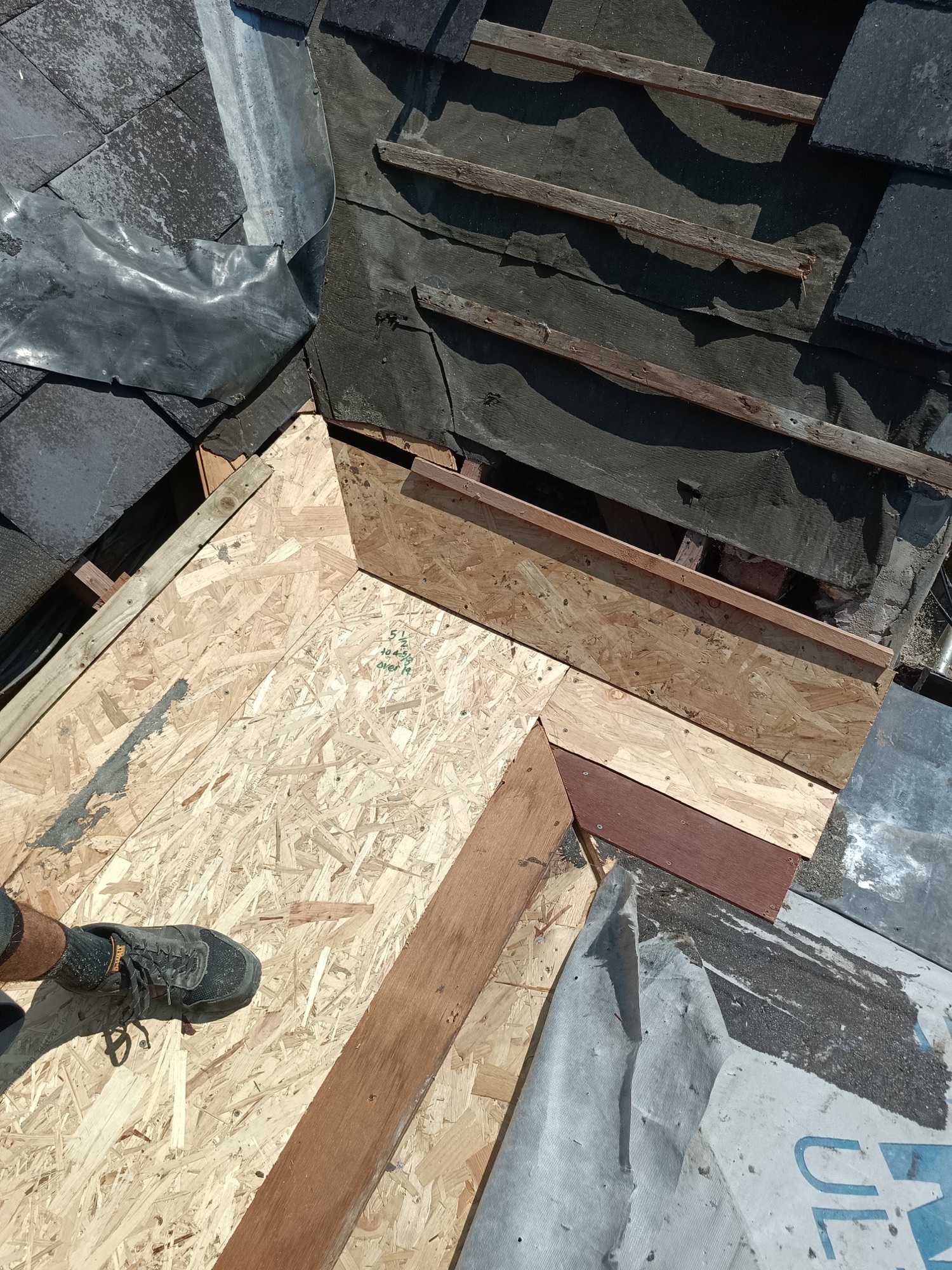

03 · Re-decked to a fall
03 · Re-decked to a fall

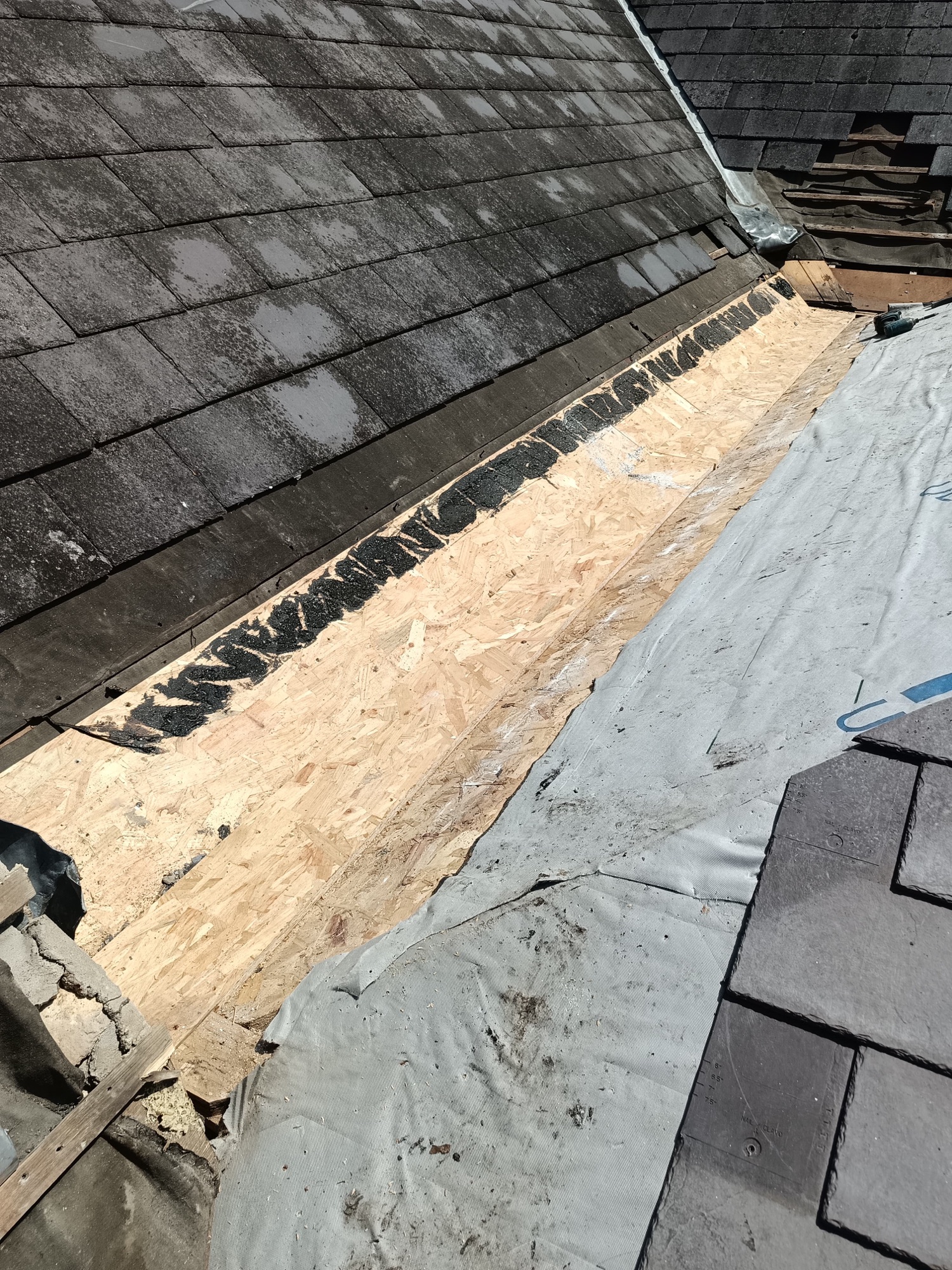

04 · Fall set out and checked
04 · Fall set out and checked

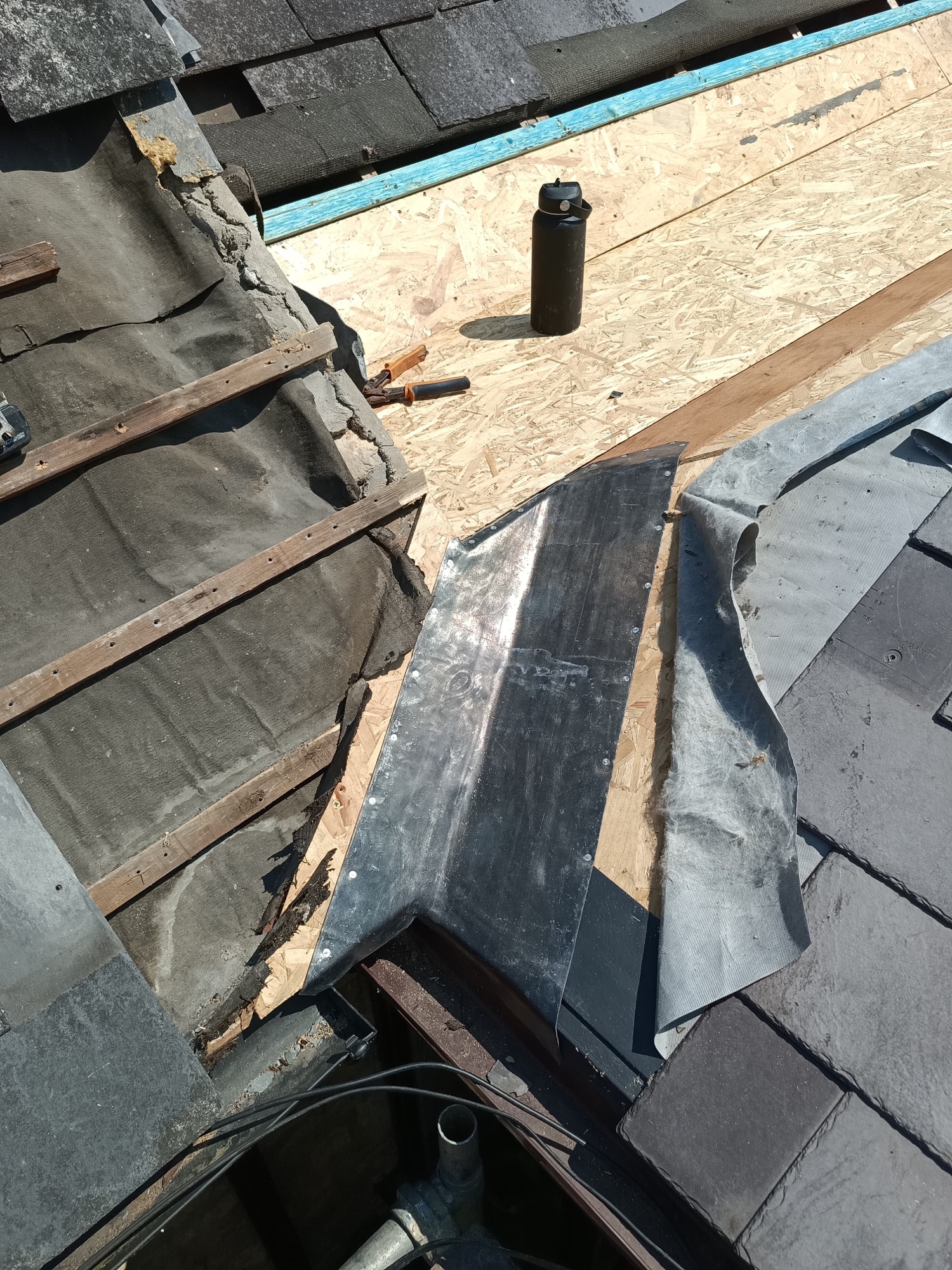

05 · Slates eased back
05 · Slates eased back

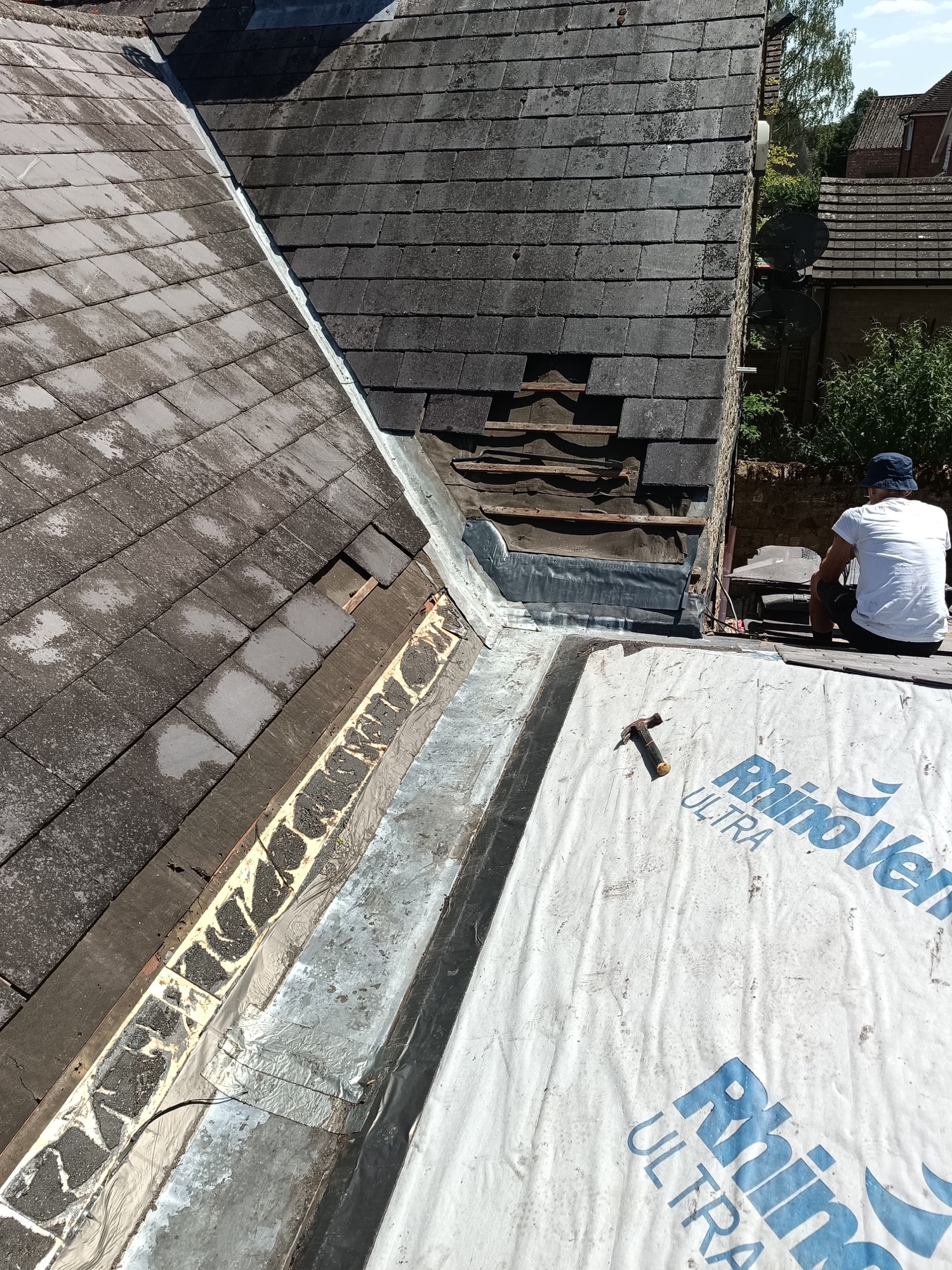

06 · Membrane and prep
06 · Membrane and prep

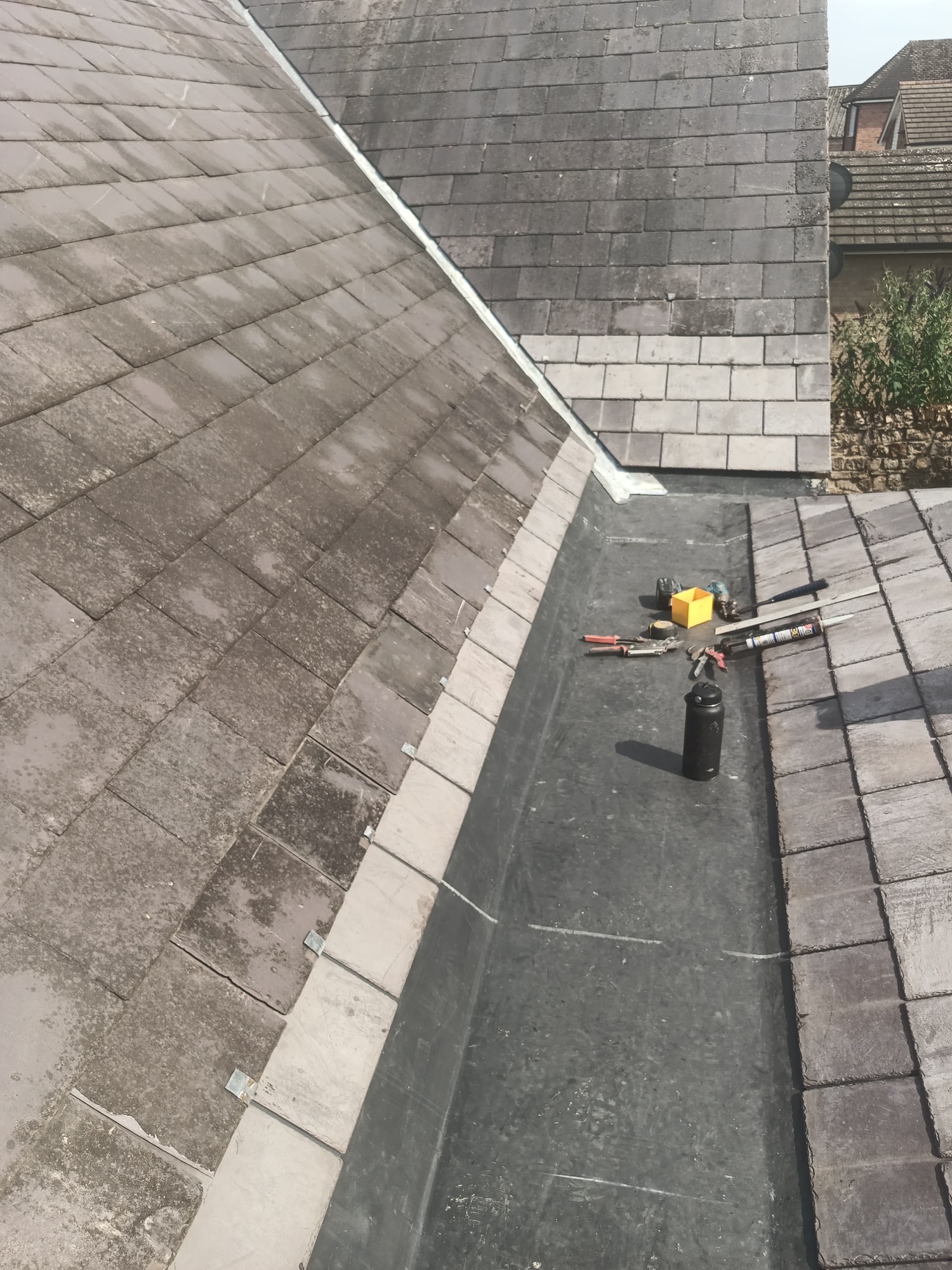

07 · Rubber dressed under the slate
07 · Rubber dressed under the slate

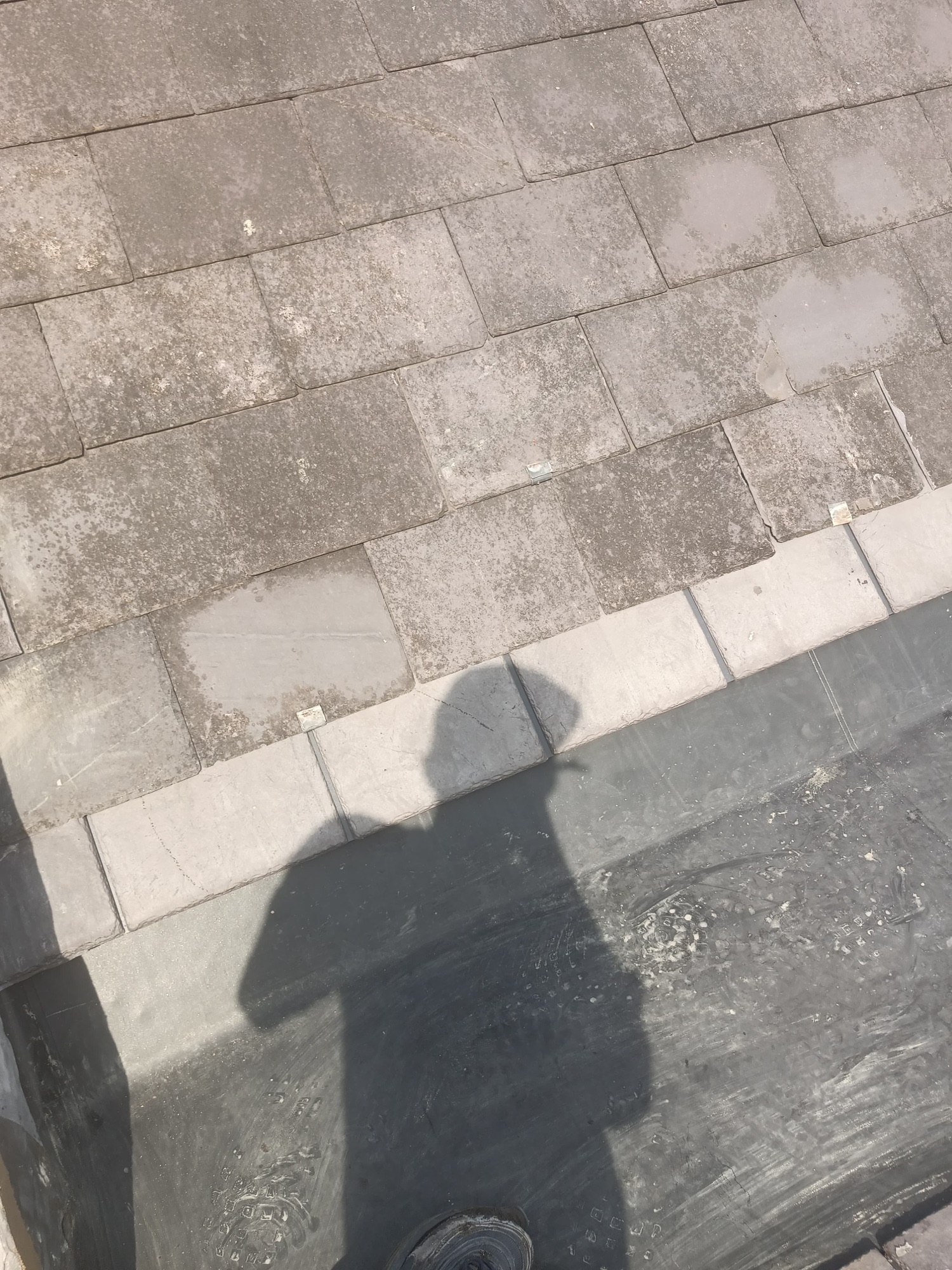

08 · Gutter lined
08 · Gutter lined

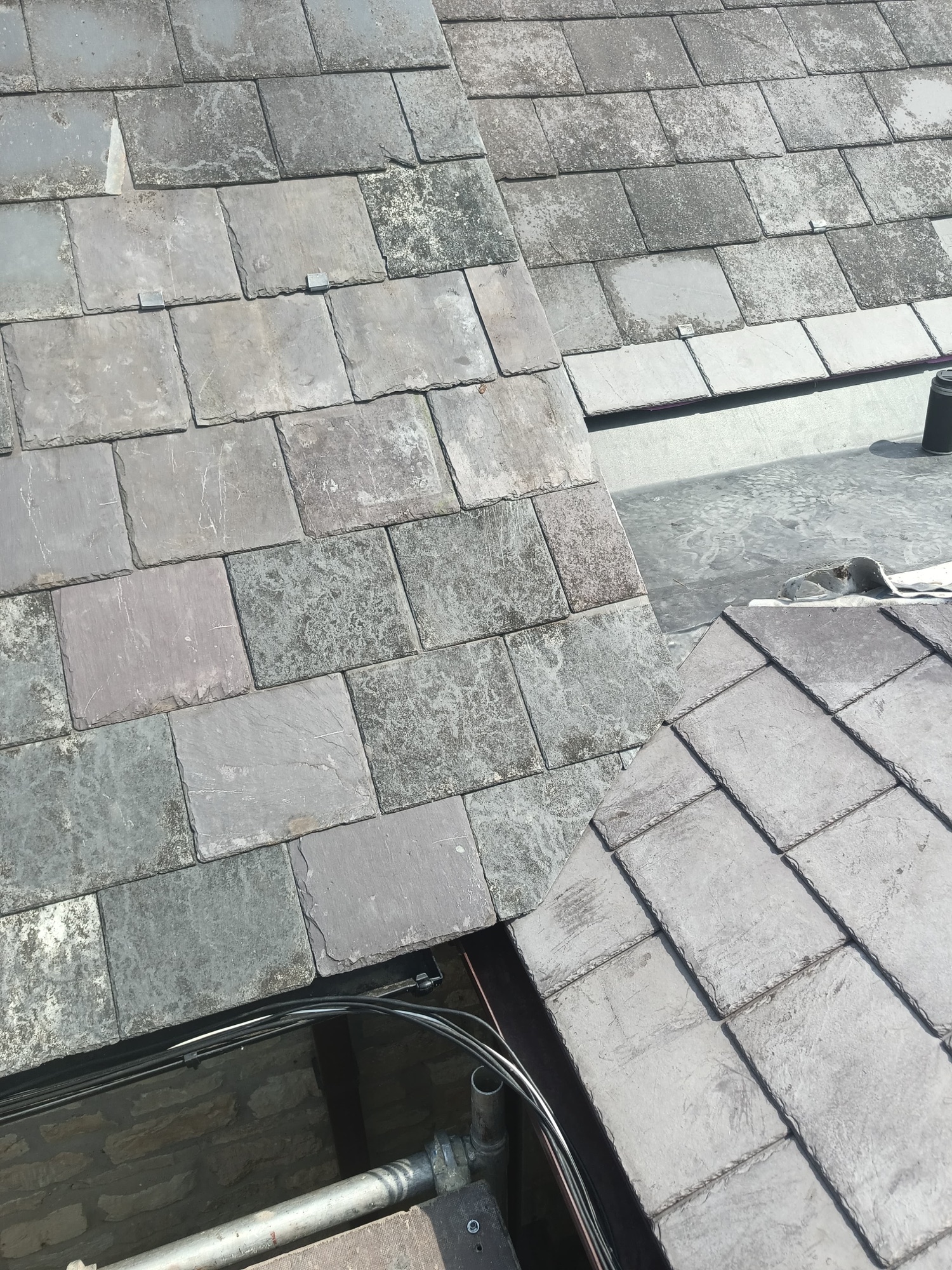

09 · Clean valley
09 · Clean valley

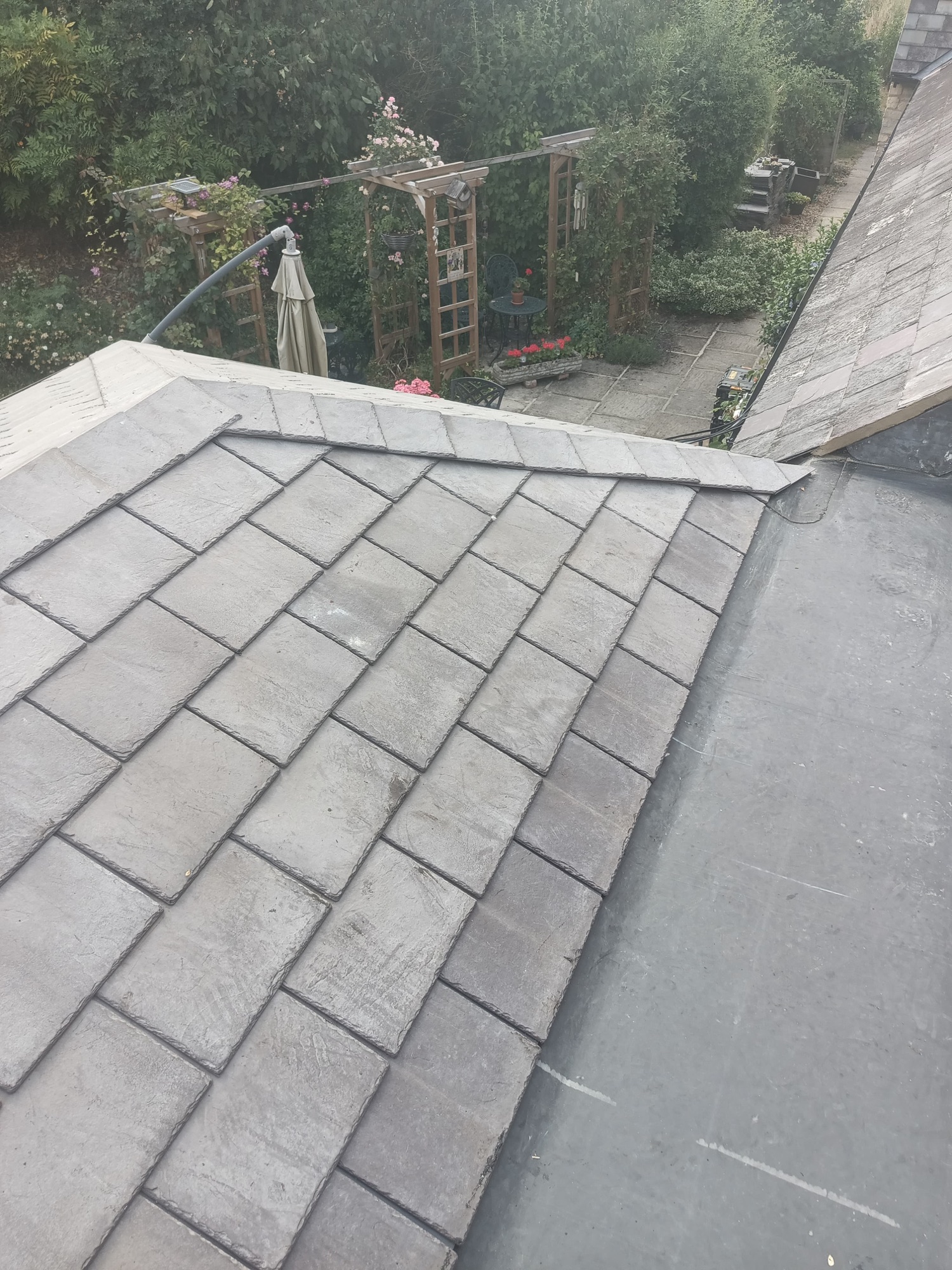

10 · Gutter and slate
10 · Gutter and slate

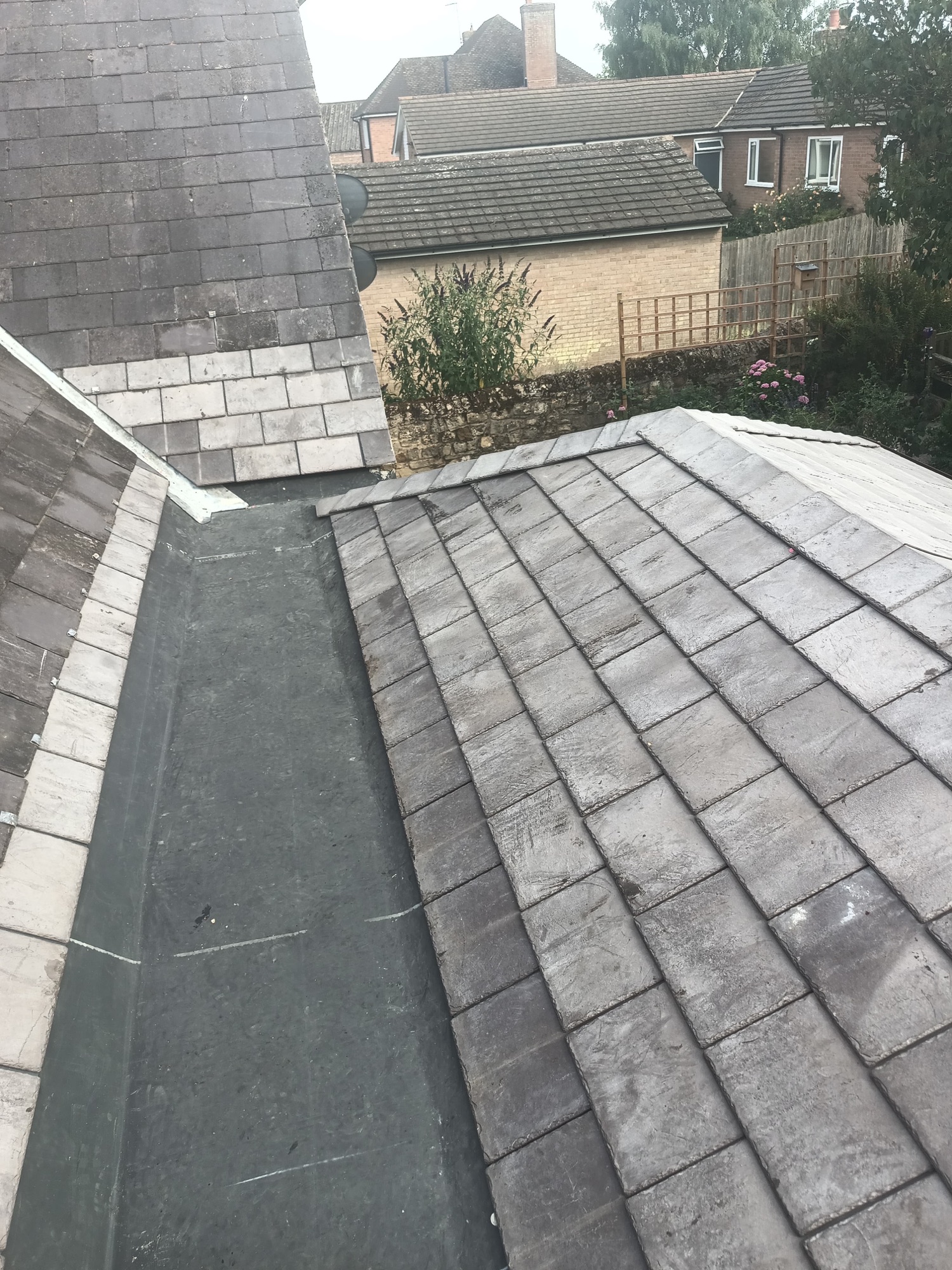

11 · Complete
11 · Complete
12 · Finished, draining
12 · Finished, draining
